Nested cabinet panels during CNC cutting

CNC Cabinet Production Workflow: Nesting to Assembly

A CNC cabinet workflow connects design, nesting, CAM, machining and assembly. Use a controlled job package with the correct files, bill of materials, revisions and identification so each stage receives consistent information. Evaluate changes against the shop’s actual constraints.


TL;DR:

  • A complete job package with locked BOM, revision number, and detailed nesting PDFs is crucial to prevent delays and remakes.

  • Batch nesting across multiple jobs improves machine utilization but requires tighter labeling discipline and consistent grain orientation.

  • Good G-code validation through collision checks, simulation, and dry runs minimizes errors and reduces rework during machining.

  • Test nesting changes against material yield while preserving grain direction, finish and assembly requirements; no fixed improvement applies to every job.

  • Investing in automation makes sense only once consistent volume exceeds current capacity, as process discipline yields more immediate benefits.


Anderson Group Australia
Bring Precision To Your Cabinet Workflow
Anderson Group Australia provides high-precision CNC machining solutions for cabinet makers and furniture manufacturers working with demanding production needs.

Explore CNC solutions

Table of Contents

What does a CNC cabinet production workflow actually look like?

Cabinet manufacturing runs through five stages: design and job release, nesting, CAM and G-code generation, CNC machining, then post-machining prep and staged assembly. This mirrors the standard flow described by AIS Cabinet’s manufacturing process, which moves from design and material selection through precision cutting to hardware fitting and quality checks.

Each stage produces a specific handoff:

  • Design/job release hands off a finished cut list, hardware BOM and revision number.

  • Nesting hands off optimised sheet layouts ready for CAM.

  • CAM/G-code hands off verified, collision-checked machine files.

  • CNC machining hands off cut, bored and labelled parts.

  • Staging/assembly hands off kitted, QC-checked units ready for install.

Shops running one or two elevations at a time can nest per job. Shops running batches across multiple kitchens do better with batch nesting across several jobs at once, which needs tighter labelling discipline but pays off in machine utilisation. A single elevation typically nests, machines and stages within a shift; full-kitchen batches often run two to three days depending on part count and edgebanding load.

How do you prepare designs and nests so the floor never stalls?

Most floor delays trace back to an incomplete job package, not a machine fault. Cutlistor’s production-prep guidance is blunt about this: release a job without a locked BOM or a revision number, and you get missing parts and remakes days later.

A complete job package needs:

  1. Nest PDFs showing exact panel placement and part orientation.

  2. A cut list matching every part to its cabinet and elevation.

  3. A hardware BOM covering hinges, slides, fasteners and shelf pins.

  4. A revision number so the floor never machines an outdated version.

  5. Machining notes flagging grain direction, finished faces and any grooving requirements.

Nesting itself has two competing goals. Yield-first nesting packs parts tight to squeeze the most out of each sheet, which suits high-volume runs where material cost dominates. Handling-first nesting leaves more breathing room around parts and groups by finish, which suits smaller shops where an extra offcut costs less than a mis-picked panel. Keep grain orientation consistent across a job, group parts by finish so you are not switching stock mid-nest, and use tabs sized to hold parts without leaving marks that need sanding out.

Pro Tip: Label parts the moment they come off the machine, not after the whole sheet is cut. A part sitting unlabelled for ten minutes is a part someone will misplace.

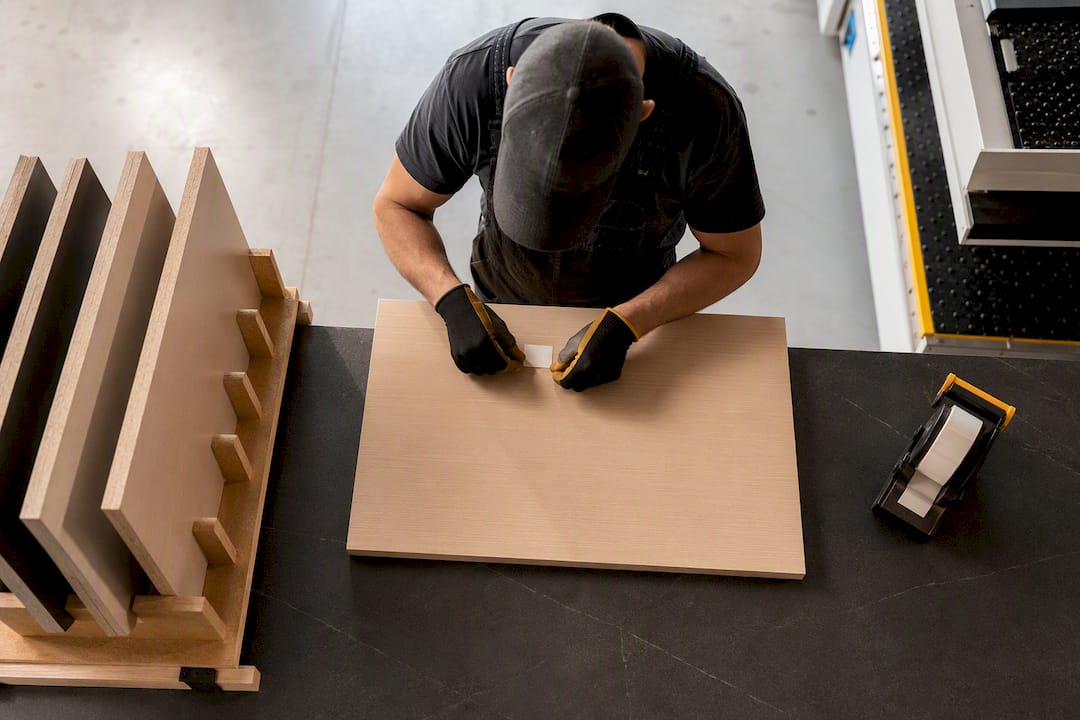

Operator labeling freshly cut cabinet part

How do you turn a cabinet design into reliable G-code?

The handoff from CAD to CAM to G-code is where good designs turn into bad cuts if nobody checks the file. G-code is the machine language your CNC controller reads to move axes, run the spindle and fire tool changes, and most cabinet shops move files between CAD and CAM as DXF or native cabinet-design formats before the CAM software generates the final G-code.

Before that file ever reaches the machine, run these checks:

  • Confirm the tool library in CAM matches the physical bits loaded on the machine, not last month’s setup.

  • Verify feeds and speeds against material thickness and the current bit’s condition, not a generic default.

  • Check lead-ins and tabbing so parts do not shift mid-cut or fall through the spoilboard.

  • Run a collision check against fixtures, clamps and the vacuum table zones you have live.

Simulate the full toolpath in software first, then do a dry run at safe height on the actual machine before cutting real stock. File transfer should follow a version-locked folder structure, one job number, one revision, no loose files floating on a USB stick.

Pro Tip: Keep a “machine-ready” folder separate from your working CAM files. Nobody should ever load a file straight from the design folder onto the router.

What machine setup and tooling reduce cabinet part rework?

Cabinet nesting rewards specific hardware choices. A nesting-capable router with a rigid gantry and a high-flow vacuum table keeps thin panels flat and parts consistent, a point industry equipment guides make repeatedly when comparing router setups for cabinet work. An automatic tool changer saves time on multi-operation jobs but adds cost and complexity that smaller shops may not need if most parts use one or two tools.

Setup priorities that actually move the needle:

  • Vacuum table zoning. Match zone size to part size so small offcuts still hold vacuum.

  • Spoilboard management. Resurface on a schedule, not when parts start lifting mid-cut.

  • Tool selection. Compression bits for melamine and veneered panels, upcut for fast waste removal, downcut where top-face finish matters most.

  • Bit life tracking. Log cutting hours per bit; swap on a schedule rather than waiting for a bad cut to tell you.

Carry out pre-start and setup checks according to the machine and tooling instructions. If accuracy is uncertain, arrange suitable diagnosis and acceptance testing rather than assuming one test or schedule will establish reliability.

What post-machining steps stop remakes before assembly?

Whether you edgeband before or after CNC cutting is a shop-rule decision, and it needs to be written into the job package, not left to whoever is running the machine that day. Pre-banding gives cleaner exposed edges on some cuts; post-machining banding suits shops cutting to exact size first. Either way, document the choice once and apply it consistently.

The sequence that keeps assembly moving:

  1. Bore and pre-fit hardware immediately after cutting, while the part is still on the cart and easy to handle.

  2. Label and kit by elevation ID, not just by job number, so a picker can find every part for one cabinet in one spot.

  3. Stage carts in build sequence, matching the order cabinets go together on the floor.

  4. Spot-check critical dimensions, hole spacing, panel squareness, edge overhang, and log a simple pass or fail against the cut list.

Shops that release a complete job package with locked BOMs and staging rules see fewer missing parts and fewer remakes reaching assembly, according to Cutlistor’s staging guidance. A five-minute QC pass at this stage is cheaper than a rebuild at install.

How can you improve yield and throughput without buying new equipment?

Test nesting changes against the current layout. Preserve grain direction, finished faces and workholding requirements, then measure material yield, remake rate and handling time for the trial jobs.

Nesting adjustments improving material yield

Scheduling matters just as much as the nest. Batch jobs by material and finish so the machine is not sitting idle waiting on a sheet change, and queue the next nest while the current one is cutting rather than after.

Track four numbers weekly:

  • Yield percentage (usable panel area versus total sheet area).

  • Parts per shift.

  • Machine utilisation (cutting time versus total shop hours).

  • Remake rate (parts recut due to error).

Test alternative nest orientations only where grain, face finish, workholding and assembly requirements allow. Compare the result with the current layout and record the trial conditions.

Building a controlled cabinet-production workflow

Assign responsibility for the job package and verify revisions, labels and nesting files before machining. Measure the result rather than promising a particular waste percentage.

A shop-tested starting kit looks like this: a locked job package template covering nest PDFs, BOM and revision control; a daily spindle and tool check logged before the first cut; and a standing nest-review meeting held before any batch goes to the machine. None of it requires new hardware, just consistent habits applied the same way every job.

When should you invest in automation instead of fixing process?

Evaluate process consistency and capacity together before investing in automation. Use the actual job mix, bottlenecks, staffing, handling time and total installed cost to compare options. Supplier examples of fully automated batch-one lines can inform the assessment, but do not establish a universal purchase threshold or payback period.

How Anderson Group Australia supports a nesting-led cabinet workflow

Anderson Australia supplies CNC machinery for cabinet and panel production. Discuss the Genesis PLUS and other suitable woodworking configurations against your sheet sizes, nesting, workholding and handling requirements. Confirm options for the exact model. Use the Genesis PLUS specification request to access its PDF.

Discuss workholding, tooling and material-handling constraints with the machinery supplier. Contact Anderson Australia to confirm suitable equipment and any evaluation or application-support options available.

Where to go for more detail

Use the related panel-processing and waste-reduction articles to prepare questions and plan trials. Confirm any specific template, service or technical support with its provider.

Sources

FAQ

What is the standard CNC cabinet production workflow?

Design and job release, nesting, CAM and G-code generation, CNC machining, then staged assembly and QC, matching the five-stage flow AIS Cabinet documents from drawing to finished cabinet.

How much material waste should a cabinet shop expect?

Material waste depends on panel sizes, part geometry, grain direction, defects, workholding and remakes. Measure the shop’s current yield and compare controlled nesting trials; no fixed waste percentage applies to every job.

Should edgebanding happen before or after CNC cutting?

Either sequence works, but the choice needs to be a written shop rule in the job package, not a decision left to whoever runs the machine that day.

What causes most CNC cabinet remakes?

Incomplete job packages, missing BOMs, unlocked revisions or poor labelling, are the most common cause, not machine error, according to Cutlistor’s production-prep analysis.

When is it worth buying a nesting-capable production machine?

Consider suitable nesting equipment when measured capacity, handling or machining constraints justify the investment. Compare the Genesis PLUS configuration and alternatives using actual production requirements, installed costs and a documented trial.
